library(ggplot2)
set.seed(1)
days <- 1:120
w <- dgamma(1:21, shape = 6, rate = 1)
w <- w / sum(w)
infectiousness <- function(inc, t) {
s <- 1:min(t - 1, length(w))
sum(inc[t - s] * w[s])
}Estimating Rt with a renewal equation
The renewal equation says that new infections today depend on recent infections, weighted by the generation interval \(w_s\), the chance that \(s\) days separate an infection from the one it causes:
\[ I_t \sim \text{Poisson}\left(R_t \sum_{s \geq 1} I_{t-s}\, w_s\right) \]
This tutorial simulates an outbreak with a known \(R_t\), then estimates it back with the approach of Cori et al. (2013), written out in base R so every step is visible. You’ll need ggplot2 for the plots.
1. Set up the generation interval
A gamma distribution with a mean of six days, cut at three weeks.
2. Simulate an outbreak
\(R_t\) is 1.5 until day 50, when a control measure brings it down to 0.8.
rt_true <- ifelse(days < 50, 1.5, 0.8)
inc <- numeric(length(days))
inc[1:5] <- 5
for (t in 6:length(days)) {
inc[t] <- rpois(1, rt_true[t] * infectiousness(inc, t))
}

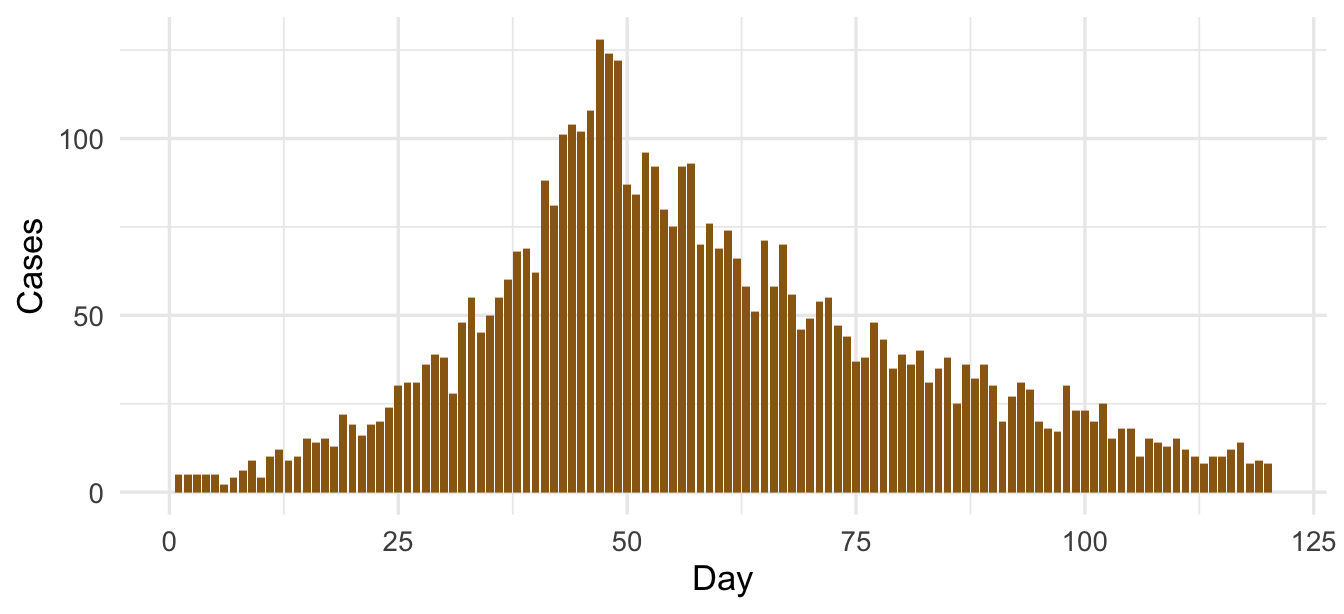

ggplot(data.frame(day = days, cases = inc), aes(day, cases)) +
geom_col(fill = "#9A6714", width = 0.85) +
labs(x = "Day", y = "Cases") +
theme_minimal(base_size = 13)
3. Estimate Rt over a sliding window
With a gamma prior on \(R_t\) (shape \(a\), scale \(b\)) and a window of \(\tau\) days, the posterior is also gamma, with shape \(a + \sum I_t\) and rate \(1/b + \sum \Lambda_t\), where \(\Lambda_t\) is the total infectiousness on day \(t\).
tau <- 7
a <- 1
b <- 5
lambda <- c(0, sapply(2:length(days), \(t) infectiousness(inc, t)))
est <- data.frame(day = 15:length(days))
est$shape <- sapply(est$day, \(t) a + sum(inc[(t - tau + 1):t]))
est$rate <- sapply(est$day, \(t) 1 / b + sum(lambda[(t - tau + 1):t]))
est$mean <- est$shape / est$rate
est$lo <- qgamma(0.025, est$shape, est$rate)
est$hi <- qgamma(0.975, est$shape, est$rate)4. Compare with the truth

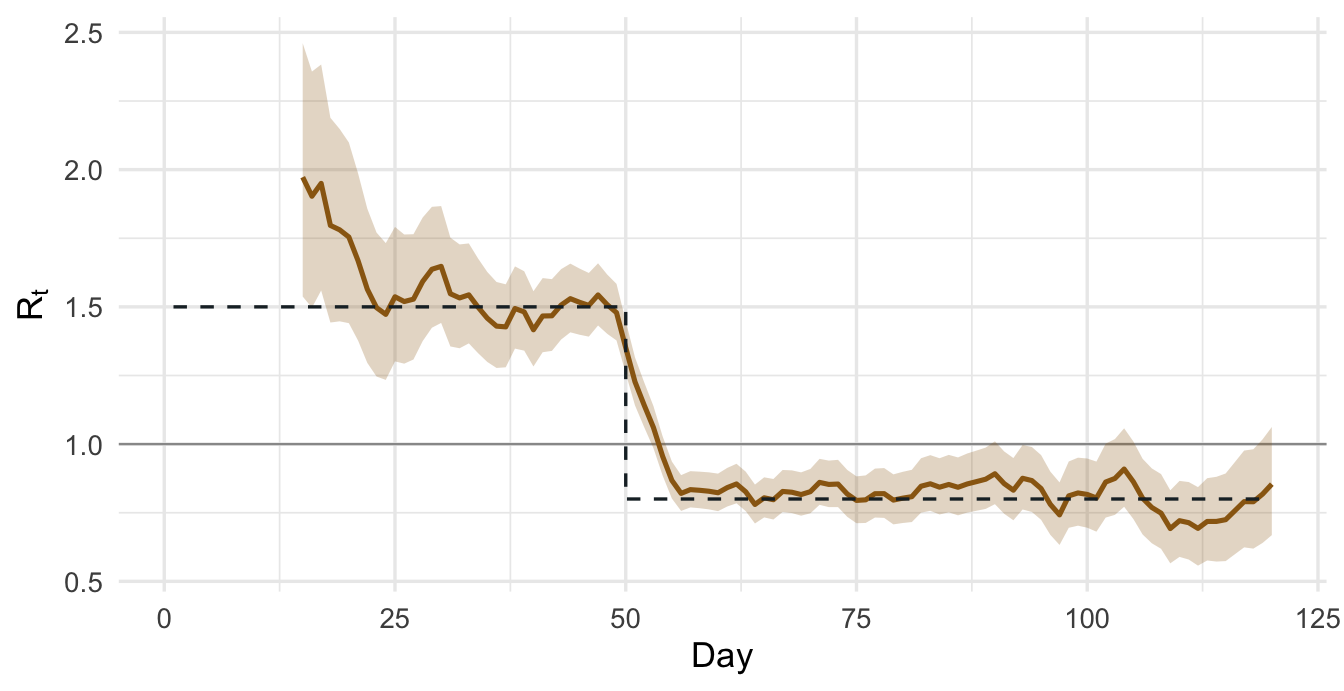

ggplot(est, aes(day)) +
geom_hline(yintercept = 1, colour = "grey60", linewidth = 0.4) +
geom_ribbon(aes(ymin = lo, ymax = hi), fill = "#9A6714", alpha = 0.25) +
geom_line(aes(y = mean), colour = "#9A6714", linewidth = 0.9) +
geom_step(data = data.frame(day = days, rt = rt_true), aes(y = rt), linetype = "dashed", colour = "#1D2930") +
labs(x = "Day", y = expression(R[t])) +
theme_minimal(base_size = 13)
The estimate tracks the true \(R_t\) and takes about a window’s length to catch up after the drop on day 50.
The generation interval for dengue or chikungunya includes the time the virus spends developing inside the mosquito, so it is longer than for a respiratory virus and changes with temperature. Imported cases also need separating from local ones, or they inflate \(R_t\). See the chikungunya primer.
